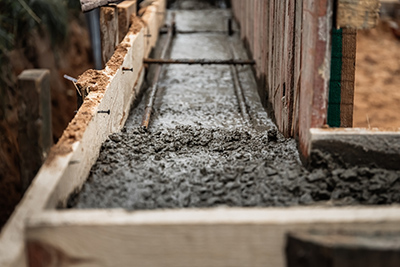

In the production of precast concrete components, accurate positioning of reinforcing bars is critical to structural safety and durability. However, rebar displacement is a common quality defect. Once it happens, it can affect the component's appearance, reduce its load‑bearing capacity, or even render the entire piece unusable. So, how can we effectively prevent rebar displacement? This article provides a systematic solution.

Why Are Rebars Prone to Displacement?
To solve the problem, we first need to understand its causes. In precast concrete production, rebar displacement typically results from the following factors:
Pouring impact – Concrete falling from the hopper or pump line directly strikes the rebar cage.
Vibration disturbance – Internal or external vibration shifts the rebars from their intended position.
Spacer failure – Rebar spacers are crushed, slip out of place, or are insufficient in number.
Formwork deformation – Side forms move outward under the lateral pressure of fresh concrete.
Lifting and transportation – Unhardened components are jolted during handling.
Eight Key Measures to Prevent Rebar Displacement
1. Use high‑precision rebar positioning frames
Dedicated rebar assembly jigs or welded positioning templates ensure consistent bar spacing and alignment. For complex precast components (e.g., composite slabs and double‑tee slabs), a CNC rebar mesh welding line is recommended – it provides strong welds and precise dimensions.
Practical tip: Calibrate positioning frames regularly (every 100 pieces or weekly) and have the operator verify the first piece.
2. Select high‑quality rebar spacers
Material: Prefer high‑strength plastic or mortar spacers; avoid fragile cement‑based ones.
Shape: Wheel‑type or conical spacers with grooves grip the bar firmly and resist slipping.
Spacing: Keep spacer spacing between 500 mm and 800 mm; place spacers on both the bottom and sides.
3. Properly arrange support bars (chairs) and tie bars
For double‑layer mesh or slab‑type members, provide enough support bars (chairs). These should be welded or tied securely, with spacing generally not exceeding 1 m. Vertical rebars can be fixed with welded positioning stirrups or temporary braces.
4. Optimize the concrete pouring sequence
Avoid pouring directly onto the rebar cage; instead, discharge concrete onto the formwork edge or a baffle and let it flow in.
Pour in layers, each 300–500 mm thick.
For deep beams or columns, use a tremie pipe or guide tube to direct the concrete flow.
5. Control vibration practices
Never rest the vibrator directly on the reinforcement.
Keep the vibrator away from spacers to avoid displacing or breaking them.
Use a high‑frequency, low‑amplitude vibrator. Vibrate just until the concrete surface shows a slurry layer and no more air bubbles rise.
6. Strengthen formwork rigidity and locking
Formwork, especially side forms, must be sufficiently rigid (lateral pressure can be calculated). Tighten the spacing of tie rods and clamping devices. Before pouring, check joints with a feeler gauge to prevent “blow‑out” that could push the rebar outward with the form.
7. Use a magnetic fixing system (for steel molds)
On flat steel pallets, strong magnetic holders or magnets can secure bar ends or spacers. This method allows flexible adjustment and precise positioning – ideal for standardized production.
8. Ensure proper early‑age curing and protection
Do not move or strike the component before the concrete has reached initial set. If early demolding is necessary, wait until the concrete has gained sufficient strength (typically ≥5 MPa). During steam curing, prevent condensation drips from impacting the rebar.
Quality Inspection and Correction
Before pouring: Use a tape measure and straightedge to verify cover thickness, bar spacing, and the number of support bars.
During pouring: Assign a dedicated person to watch continuously; stop and adjust immediately if any issue is spotted.
After demolding: Randomly check cover thickness in key areas with a rebar scanner.
If minor displacement occurs, it can be corrected by local chiseling, repositioning, and grouting. Severe displacement, however, means the piece must be scrapped – do not compromise.
“Prevention is better than cure” – this saying is especially true for precast concrete production. Rebar movement may seem like a minor issue, but it can trigger a chain of quality problems. With high‑precision positioning tooling, sound process parameters, and rigorous stage‑by‑stage inspection, you can eliminate this stubborn defect for good. We hope these eight measures bring tangible quality improvements to your precast production line.
